At some point a growing interior firm faces a capital decision: build a production unit, or find someone else's. Building one is a serious commitment — machinery, a shed, skilled operators, working capital tied up in board stock, and a fixed cost that does not care whether this month's order book is full.
White-label manufacturing is the alternative. Someone else's factory produces to your specification, under your brand, and you carry none of the fixed cost.

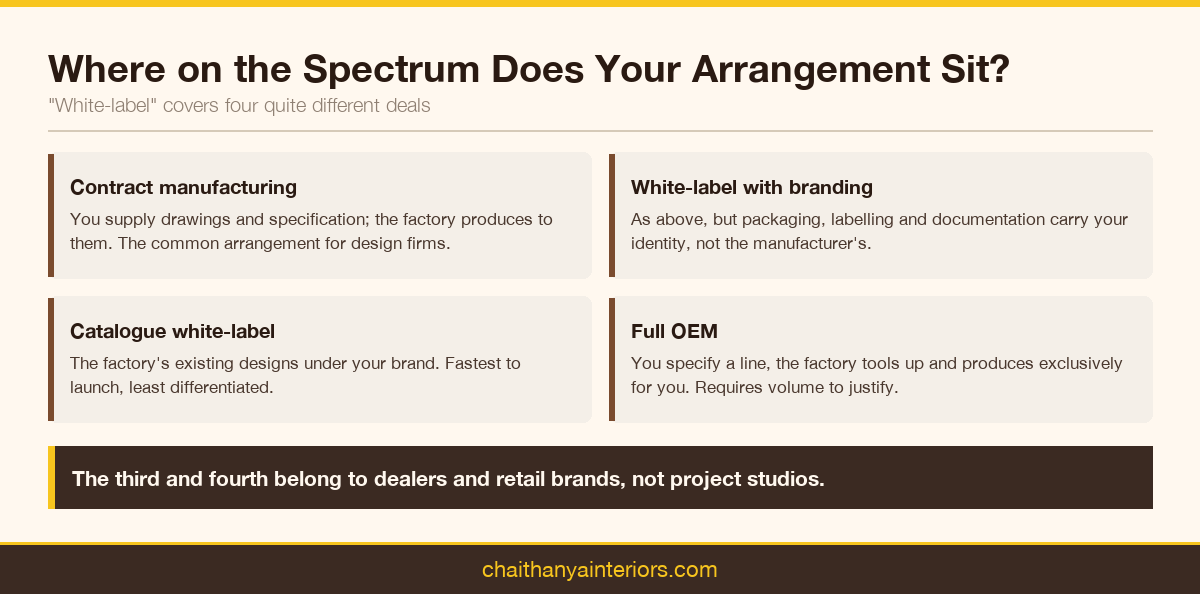

In practice the term covers a spectrum, and it is worth being precise about where on it an arrangement sits.
Most Kerala design studios need the first or second. The third and fourth belong to dealers and retail brands.

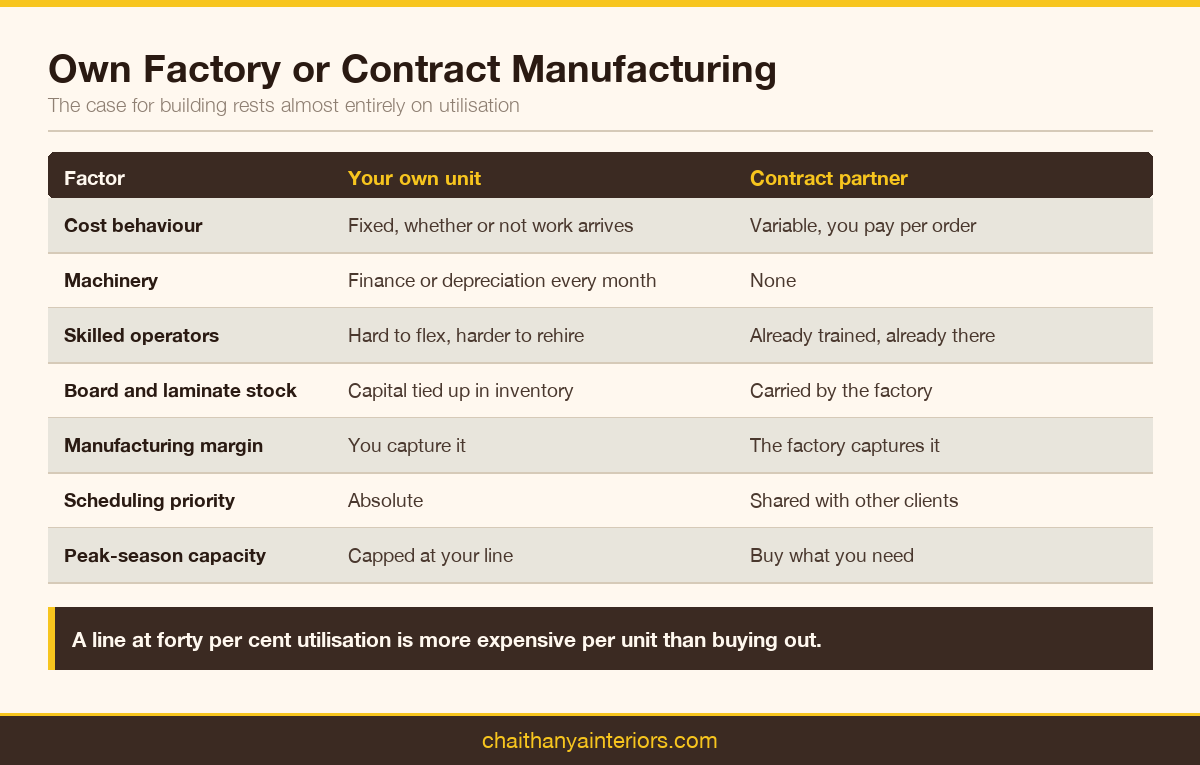

The case for your own factory rests almost entirely on utilisation. A production line that runs at capacity is cheaper per unit than buying out. One that runs at forty per cent is considerably more expensive, and most studio-owned units run well below capacity because order flow is lumpy.
The fixed costs that do not go away in a slow month:
Against that, a contract arrangement converts the whole lot into a variable cost per order. You pay when you have work.
The honest counter-argument is control and margin. Your own unit captures the manufacturing margin and answers to you alone. That is real, and it is why firms above a certain steady volume do eventually build. The question is whether you are at that volume yet, and most firms reach it later than they think.

Three things, and they should be weighed properly.
Scheduling priority. You are one client among several. A factory with its own retail order book may prioritise it in a busy season, which is worth asking about directly.
Absolute finish control. You specify, and the factory executes. A specification discipline closes most of that gap but not all of it.
Margin. The manufacturing margin sits with the factory. You are buying capacity and predictability with it.

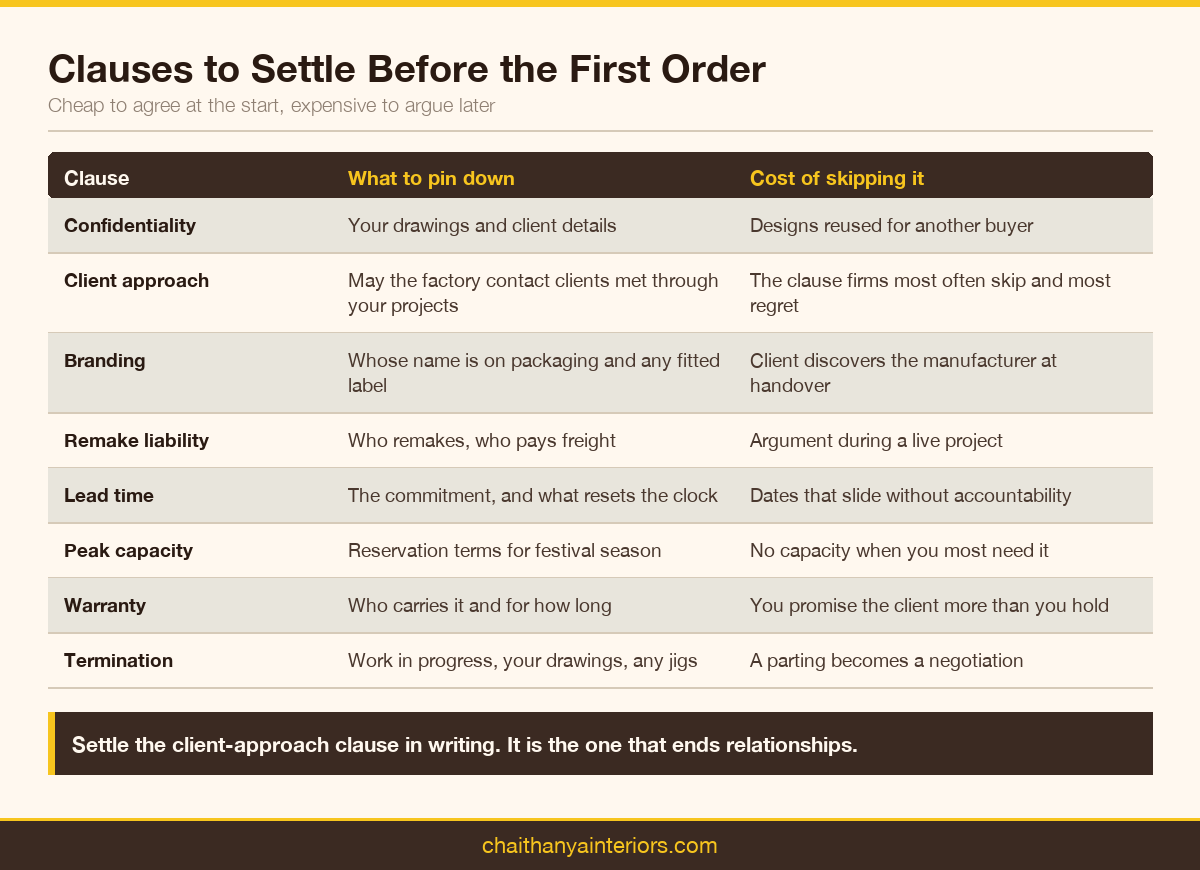

A contract manufacturing relationship runs on a handful of clauses that are cheap to agree at the start and expensive to argue later.
The client-approach clause is the one firms most often skip and most often regret. Settle it in writing.

Run a pilot. Take one project, ideally a straightforward one with a tolerant client, and put it entirely through the partner. That surfaces the gaps in your specification template, tests the factory's query discipline, and gives you a real lead time rather than a quoted one.
Then run a second. If the second goes better than the first, the relationship is working; if it goes the same, your specification is the constraint, not the factory.
Chaithanya Interiors manufactures for design firms, architects and builders from its own unit in Kochi alongside its direct residential work. You can see how the units are actually built, review the full product range, look through completed project photographs, or talk to the team about a pilot project.
Studios moving to bought-in production often mishandle pricing at first, usually by treating the factory invoice as their cost and adding a thin margin. That undercounts what the studio actually does.
The studio still carries design time, specification, client management, site measurement, coordination with other trades, installation supervision, snagging and warranty handling. None of that is in the factory invoice, and all of it is real cost.
Price the delivered result to the client and treat manufacturing as a direct project cost, exactly as you would treat any subcontract. That keeps the studio's own value visible in the quote rather than buried.
Firms that grow past a certain volume usually end up with more than one manufacturing partner, for capacity and for resilience. That brings its own discipline.
Beyond the clauses already listed, two provisions are worth particular attention in a white-label arrangement.
Warranty. Establish who carries it, for how long, and what it covers. A client who has bought from your studio will come to your studio, and you need to know what you can promise. Get the factory's warranty terms in writing and make sure yours to the client are not wider than theirs to you.
Termination and transition. If the relationship ends, what happens to work in progress, to your drawings held by the factory, and to any tooling or jigs made for your designs? A short clause settles it. Its absence turns a straightforward parting into a negotiation at the worst possible moment.
Contract manufacturing is not a way to get the benefits of a factory for free. You are exchanging margin and absolute control for flexibility and a much lower fixed cost base.
For most Kerala design studios, and for essentially all of them below steady high volume, that exchange is straightforwardly favourable. The firms it does not suit are the ones with predictable, high, year-round throughput and the capital to build properly. Those firms exist, and they should build. The mistake is assuming you are one of them before the order book says so.
A studio that outsources still owns the client relationship, and that means owning the problems too. When a unit arrives wrong, the client does not want to hear about the factory.
Practically, that means holding enough margin and enough schedule contingency to absorb a remake without it becoming the client's problem, and never introducing the manufacturer into a dispute as an explanation. The studio specified it, the studio approved the production drawing, and the studio carries it.
Firms that handle this well find the factory relationship strengthens, because the factory is not being asked to face a client it never sold to.
